Skip to main content

Program Overview


The goal of the Electric Vehicle ("EV") Make-Ready Program ("EV Make-Ready Program") is to support the development of electric infrastructure and equipment necessary to accommodate an increased deployment of EVs within New York State by reducing the upfront costs of building charging stations for EVs. Through this EV Make-Ready Program, entities seeking to install or participate in the installation of Level 2 ("L2") and/or Direct Current Fast Charging ("DCFC") chargers can earn incentives that will offset a large portion of, or in some cases, all of the infrastructure costs associated with preparing a site for EV charger installation.

The New York Public Service Commission's November 16th, 2023 Order Approving Midpoint Review Whitepaper's Recommendations with Modifications and September 20, 2024 Order Approving Modifications to the Make-Ready Program mandated several important program updates. All information on this webpage has been updated to reflect up-to-date information about the current program requirements. The updated Participant Guide for the program can be found here.


Program at a Glance

  • Supports CLCPA goals as well as New York State’s zero-emission vehicle (ZEV) goal of deploying 850,000 electric vehicles across the state by 2025.
  • Total program budget is $1.243 billion, with more than $885 million allocated to support Make-Ready Programs by the New York Joint Utilities.
  • $372.5 million must directly benefit Disadvantaged Communities. Disadvantaged Communities are defined as communities that bear burdens of negative public health effects, environmental pollution, impacts of climate change, and possess certain socioeconomic criteria, or comprise high concentrations of low- and moderate-income households. More information about Disadvantaged Communities in New York can be found on NYSERDA's website.

What's Included

Take advantage of the make-ready incentives available through your utility to help install EV charging.



Light-Duty EV Make-Ready Program

Available Incentives

You may be eligible for up to 100% of the electric infrastructure costs associated with new non-residential EV charging stations. Participating in the Make-Ready Program will also reduce your organization's time investment by providing a dedicated point of contact and streamlined, step-by-step experience installing your electric vehicle charging stations.



How to Participate

Your utility is here to help you make the switch to electric by helping bring down the cost of installing EV charging stations. Here’s how it works:



Eligible Equipment

Depending on the date a project enters a program agreement with a utility (Commitment Date), chargers installed through the Make-Ready Program must comply with the following technical standards:

  • DCFC
    • Chargers committed on or after December 16, 2023 must use hardware conformant with ISO 15118-3 and capable of enabling ISO 15118-2 or -20. Once installed, they must be able to run software conformant to ISO 15118-2 or -20 standards by November 16, 2024.
    • Chargers committed on or after November 16, 2024 must meet the requirements specified in the bulleted point above and run software conformant to ISO 15118-2 or -20 standards once installed.
    • Chargers committed on or after November 16, 2024 must also use hardware conformant with OCPP 2.0.1 or later.
  • All L2 projects committed on or after June 1, 2025 must use:
    • Chargers that are hardware conformant with ISO 15118-3 and capable of enabling ISO 15118-2 or -20.
    • Chargers that are software conformant with ISO 15118-2 or -20.
    • Chargers that are hardware conformant with OCPP 2.0.1 or later.

Additionally, effective June 26, 2023, all EVSE sold in New York must be certified with ENERGY STAR V1.0 (April 2017) or V1.2 energy efficiency standards, per the Advanced Building Codes, Appliance and Equipment Efficiency Standards Act of 2022. Please refer to the New York State Appliance and Equipment Efficiency Standards for more information on the current standards.

For DCFC projects with Agreements issued after October 18, 2024, the JU will reference the updated eligible equipment list described below to confirm hardware conformance. Manufacturers are encouraged to complete the Manufacturer Disclosure Form for DCFC equipment immediately and for L2 equipment ahead of June 1, 2025. See the table below for a breakdown of the requirements by Commitment Date.



L2

DCFC



Committed before June 1, 2025

Committed on or after June 1, 2025

Committed before December 16, 2023

Committed between December 16, 2023 and November 15, 2024

Committed on or after November 16, 2024

ISO 15118 hardware conformance

No requirement

ISO 15118-3, capable of enabling ISO 15118-2 or ISO 15118-20

No requirement

ISO 15118-3, capable of enabling ISO 15118-2 or ISO 15118-20

ISO 15118-3, capable of enabling ISO 15118-2 or ISO 15118-20

ISO 15118 software conformance

No requirement

ISO 15118-2 or ISO 15118-20

No requirement

ISO 15118-2 or ISO 15118-20 by November 16, 2024

ISO 15118-2 or ISO 15118-20

OCPP hardware conformance

No requirement

OCPP 2.0.1 or later

No requirement

No requirement

OCPP 2.0.1 or later




For contractors or customers

Starting on the dates noted above, all projects will be required to use compliant EVSE to receive Make-Ready Funding. In addition, the resource for customers to certify eligible equipment will transition from the Joint Utilities Eligible Equipment List to the EPRI Vetted Product List (VPL). Developers should reference the appropriate eligibility list based on project commitment date and installation date to find EVSE makes and models that adhere to the Joint Utilities EV Make-Ready Program Requirements:

Applicable Customer Projects

Customer Action to Take

DCFC projects committed between 12/16/23 and 11/16/24 and installed before 11/16/24

  • Confirm that EVSE installed is included on the JU Eligible Equipment List
  • Make sure that your EVSE is software conformant by November 16, 2024

DCFC projects committed between 12/16/23 and 11/16/24 and installed after 11/16/24

  • Confirm that your equipment is listed on the EPRI VPL as compliant with ISO 15118 hardware and ISO 15118 software requirements
  • If a customer chooses a charger that appears on the JU Eligible Equipment List but not on the EPRI VPL, it is the customer's responsibility to choose a charger that meets the ISO software requirement; this information will be available on the JU Eligible Equipment List. In these cases, customers should still encourage their OEMs to apply to have their chargers vetted by EPRI for future projects.

DCFC projects committed on or after 11/16/24

  • Confirm that your equipment is listed on the EPRI VPL as compliant with ISO 15118 hardware, ISO 15118 software, and OCPP hardware requirements.
  • If a customer chooses a charger that appears on the JU Eligible Equipment List but not on the EPRI VPL, it is the customer's responsibility to choose a charger that meets the ISO software requirement and the OCPP hardware requirement; this information will be available on the JU Eligible Equipment List. In these cases, customers should still encourage their OEMs to apply to have their chargers vetted by EPRI for future projects.

Level 2 projects committed before 6/1/25

  • No requirements for equipment used

Level 2 projects committed after 6/1/25

  • Confirm that your equipment is listed on the EPRI VPL as compliant with ISO 15118 hardware, ISO 15118 software, and OCPP hardware requirements.



Eligible Equipment List



For Original Equipment Manufacturers

Starting March 1, 2025, chargers will be required to be listed on the EPRI Vetted Product List (VPL) to be eligible for the Make-Ready Program. At that time, the Joint Utilities Eligible Equipment List will be archived and become inaccessible to Make-Ready Program participants. Therefore, OEMs are encouraged to apply to have their chargers vetted by EPRI as soon as possible before the Joint Utilities Eligible Equipment List is retired. Visit the EPRI VPL and click the "Vendor Application" tab to apply.

Effective November 16, 2024, all DCFCs committed through the Make-Ready Program on or after December 16, 2023 are required to be running software that conforms to either the ISO 15118-2 or -20 software standards. In addition, all DCFCs committed after November 16, 2024 are required to have hardware that conforms to OCPP 2.0.1 or later. All DCFC equipment that is not confirmed to meet these requirements on November 15, 2024 will be removed from the Eligible Equipment List on that date. In advance of that date, charger models' compliance status with each requirement is indicated in the appropriate columns on the Eligible Equipment List linked above. Manufacturers looking to confirm their equipment's compliance with these requirements can do so by filling out the Manufacturer Disclosure Form linked below.

OEMs looking to add their equipment to the Joint Utilities Eligible Equipment List can do so by filling out the Manufacturer Disclosure Form and emailing it to info@jointutilitiesofny.org

Manufacturer Disclosure Form

For white-labeled equipment to be eligible for the Make-Ready incentive, 2 additional forms must be submitted:

EV Charger Equipment Third-Party Certification Form - Brand

EV Charger Equipment Third-Party Certification Form - OEM

Representatives from both the white-labeling brand and the OEM must certify that the white-labeled equipment is not modified from the original model and that the brand is under contract to distribute white-labeled equipment.



Approved Contractors

All customers must select an Approved Contractor who will partner with them to install the right EV solution on site. Approved Contractors will walk customers through the Program details, application process and project construction.

Electrical contractors interested in installing EV charging stations under the Make-Ready Program may apply to become Approved Contractors through the Joint Utilities website.



Utility Resources

Below you can access each company’s EV Make-Ready Program landing pages where customers can find more information and resources to apply for the MRP. If you have questions or need assistance with the MRP, please email your utility at the correct address below.

Utility

Email

Website

Central Hudson

EVMakeready@cenhud.com

Electric Vehicle Make-Ready Infrastructure Program

Con Edison

EVMRP@coned.com

Electric Vehicle PowerReady Program

National Grid

EVNationalGridUNY@nationalgrid.com

Electric Vehicle Charging Station Programs

NYSEG

EVPrograms@nyseg.com

Electric Vehicle Charger Make-Ready Program

RG&E

EVPrograms@rge.com

Electric Vehicle Charger Make-Ready

Orange and Rockland

ev@oru.com

Electric Vehicle Make-Ready Program

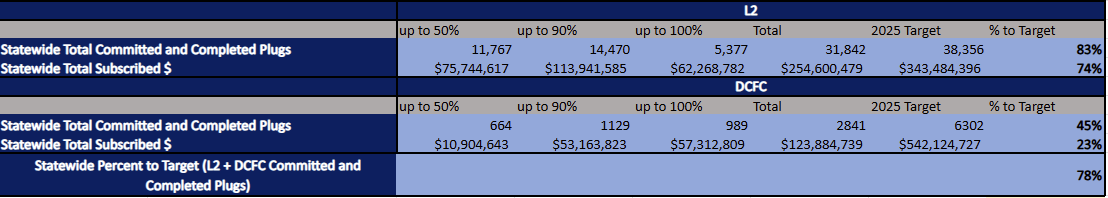

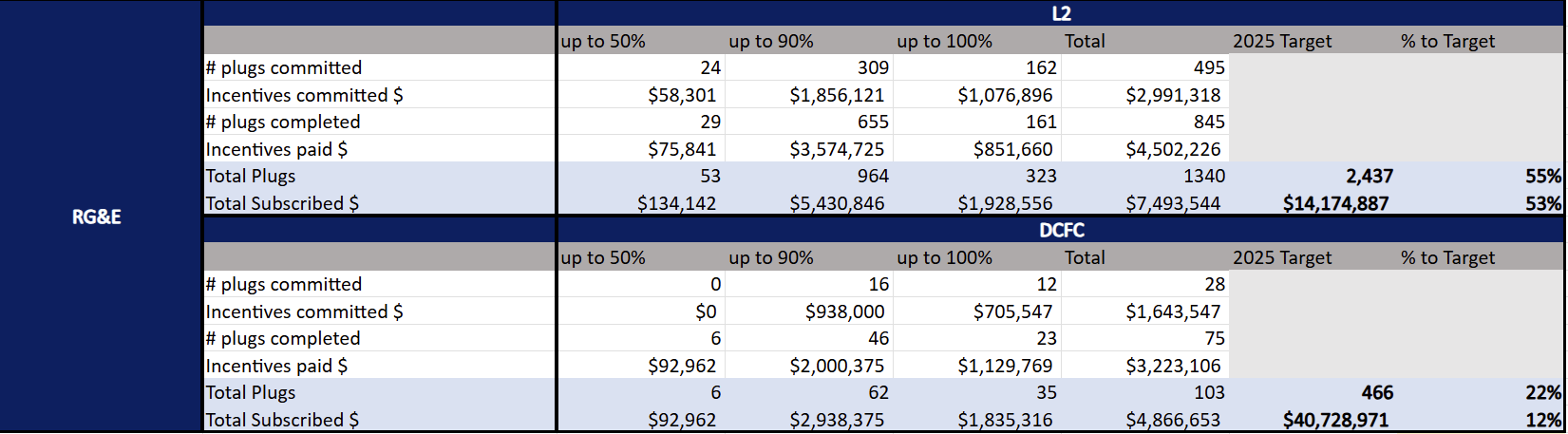

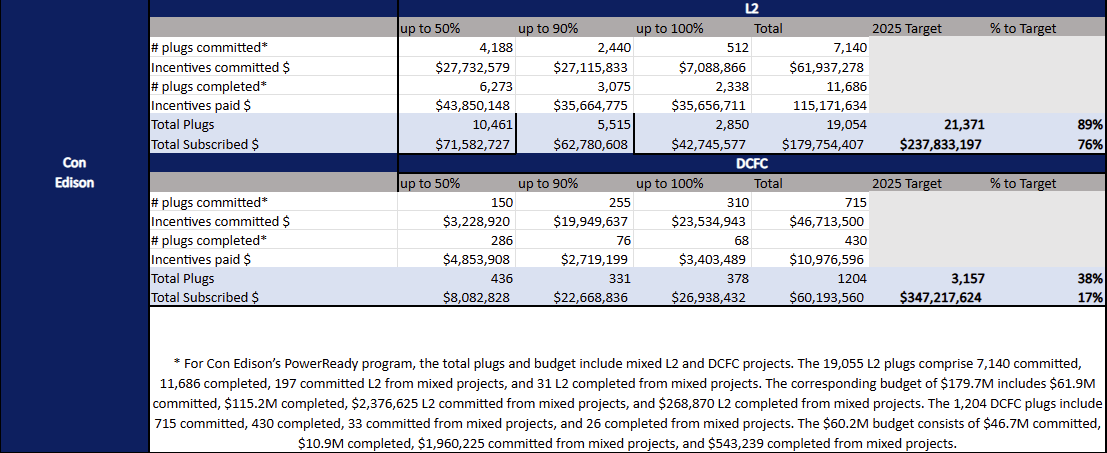

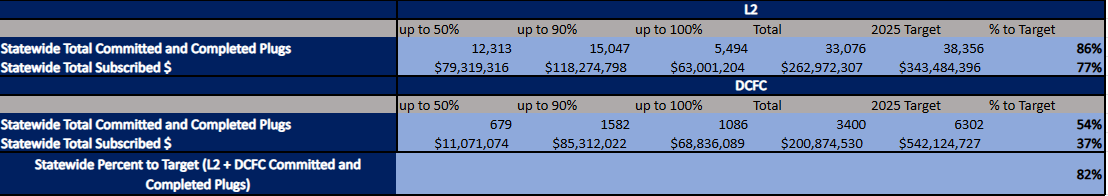

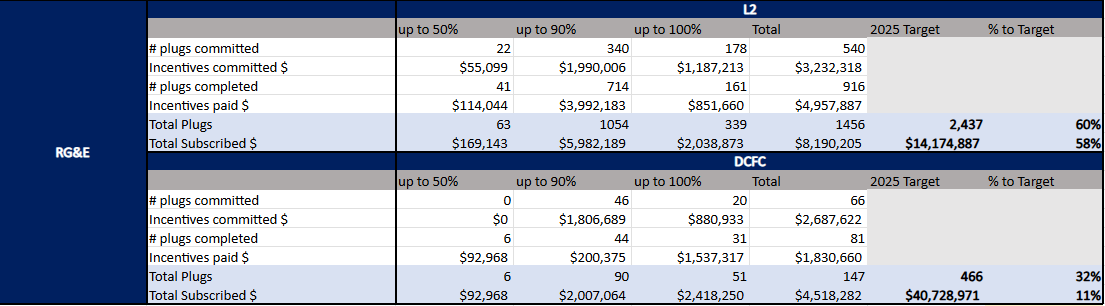

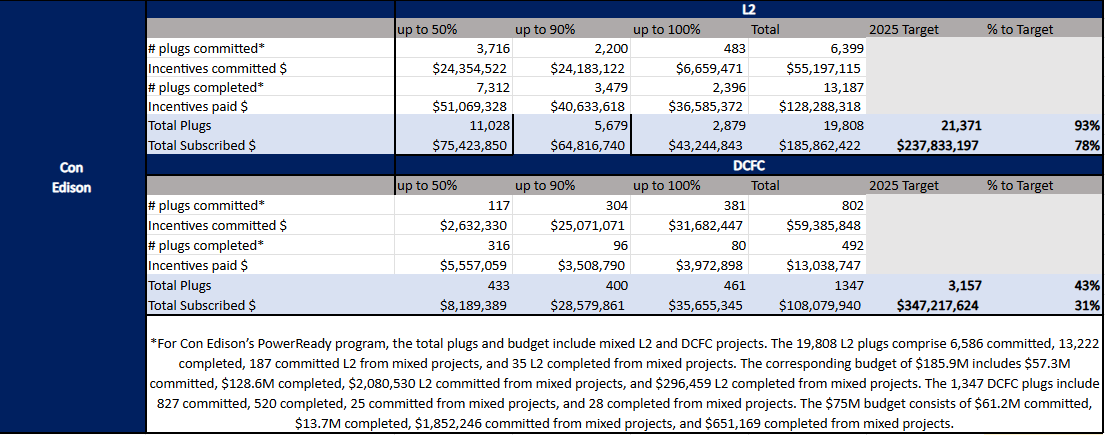

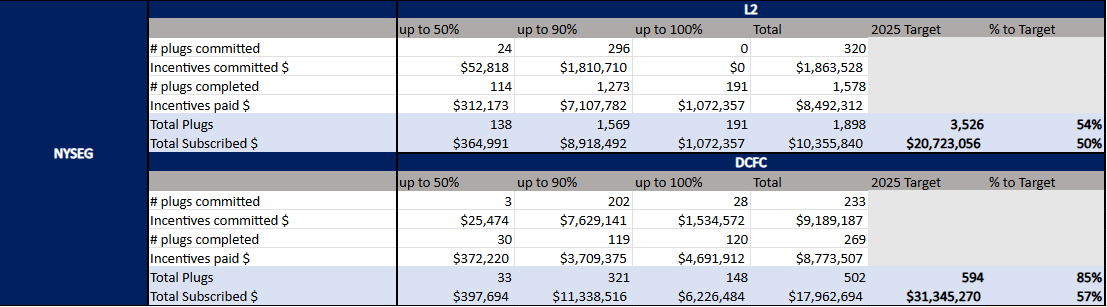

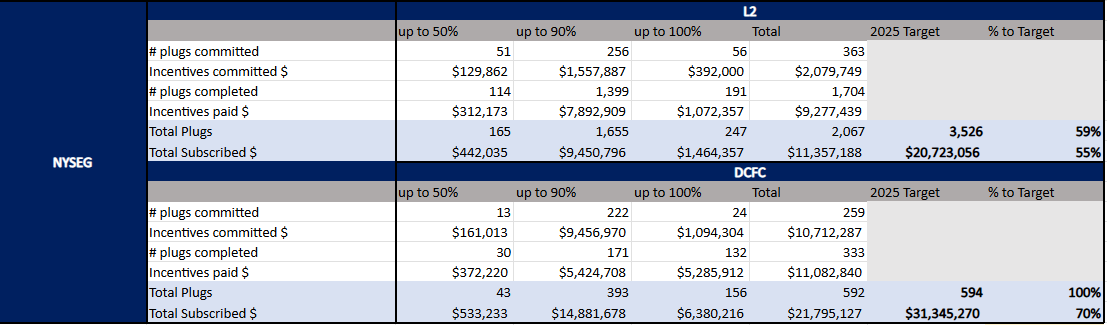

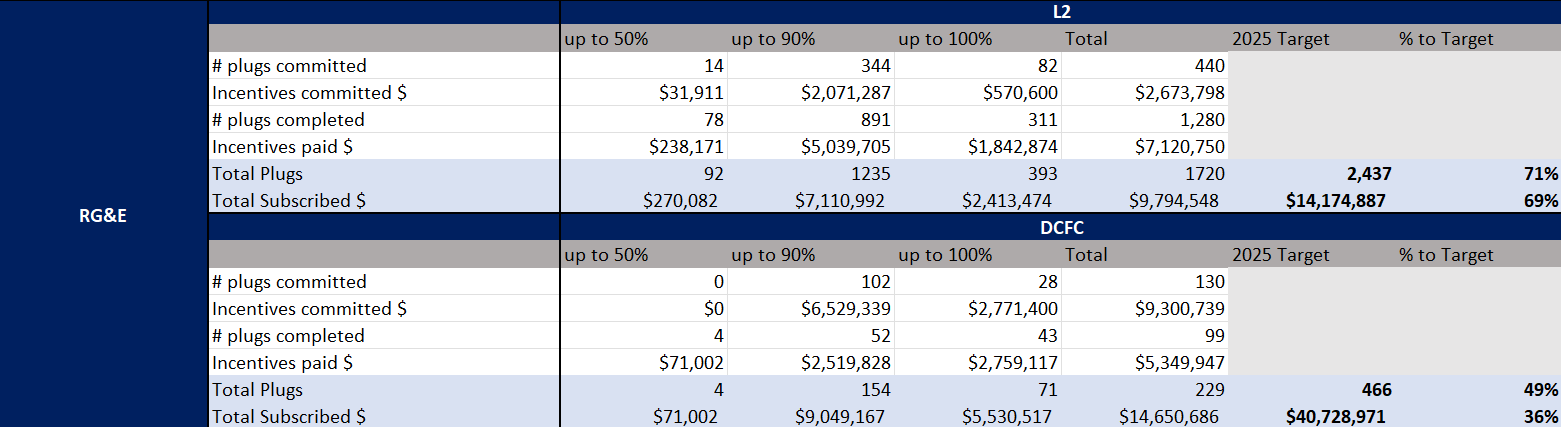

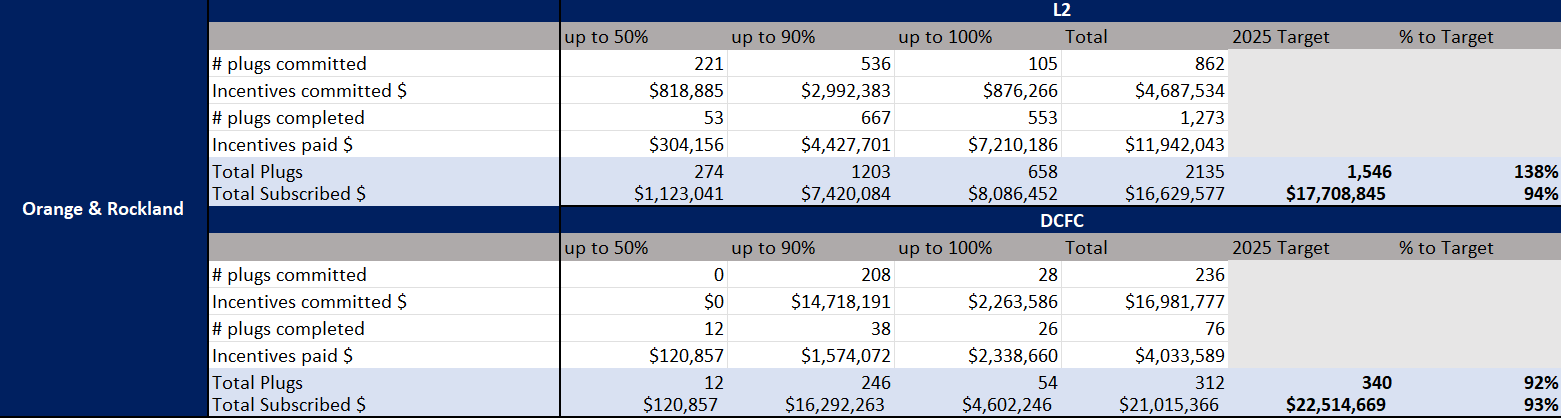

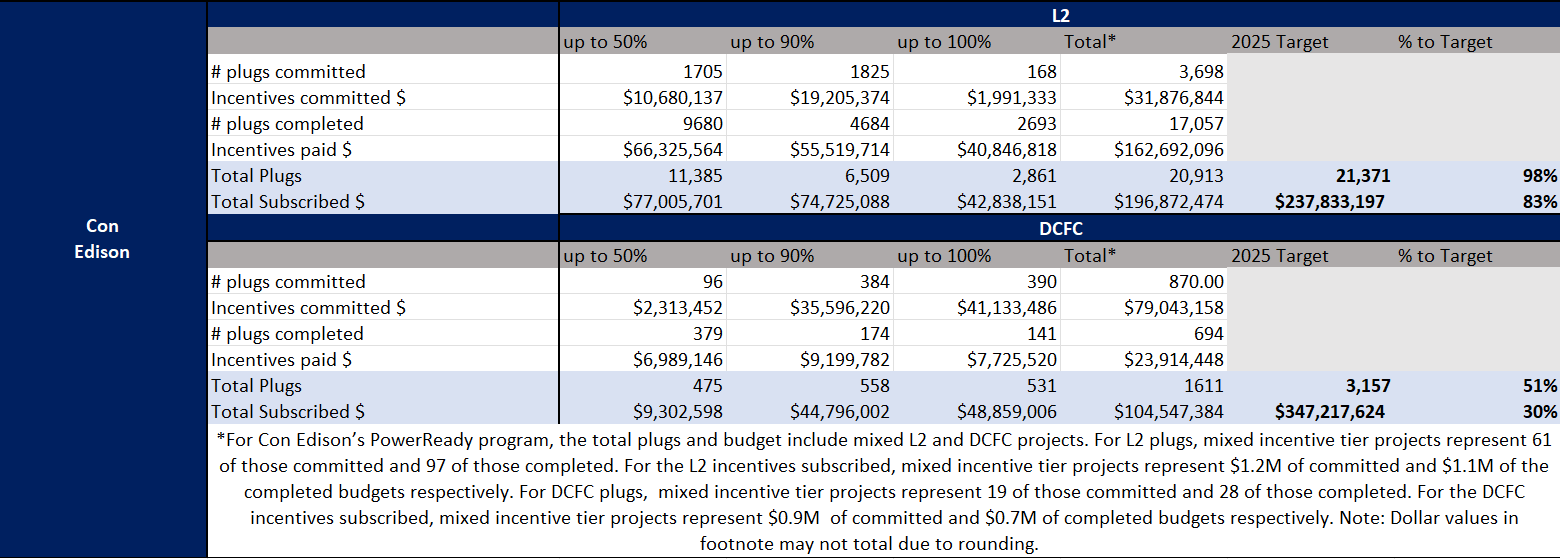

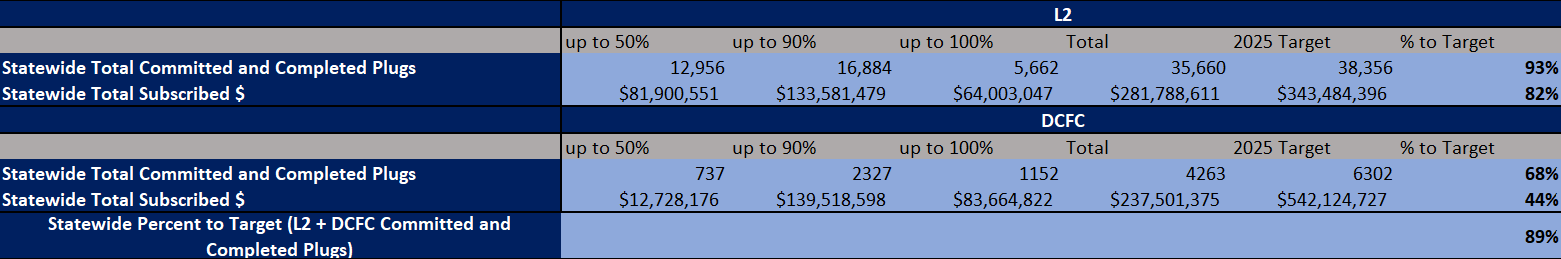

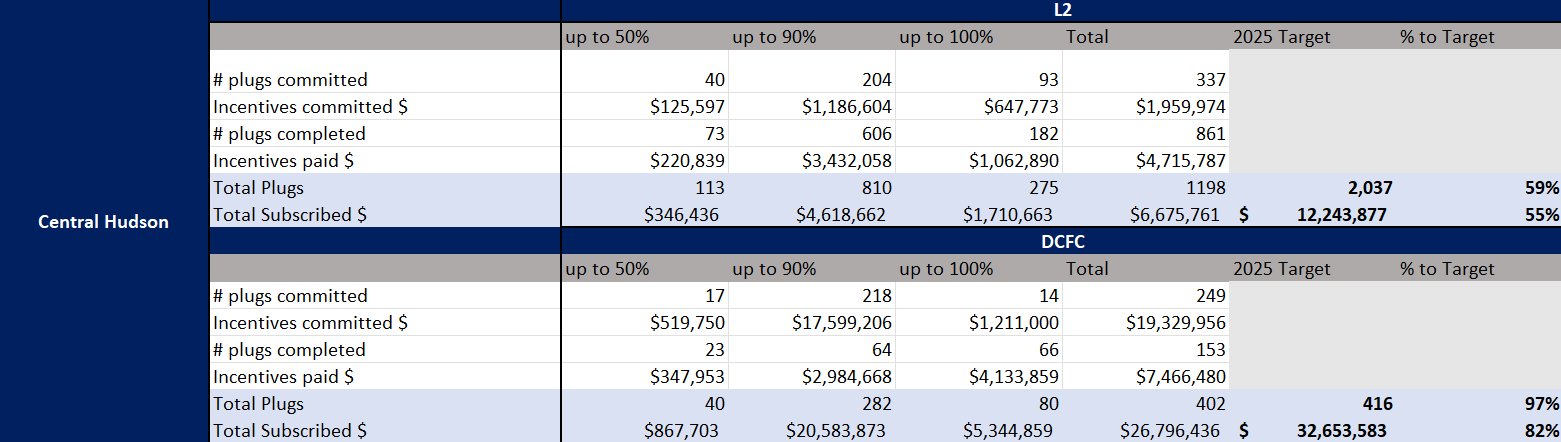

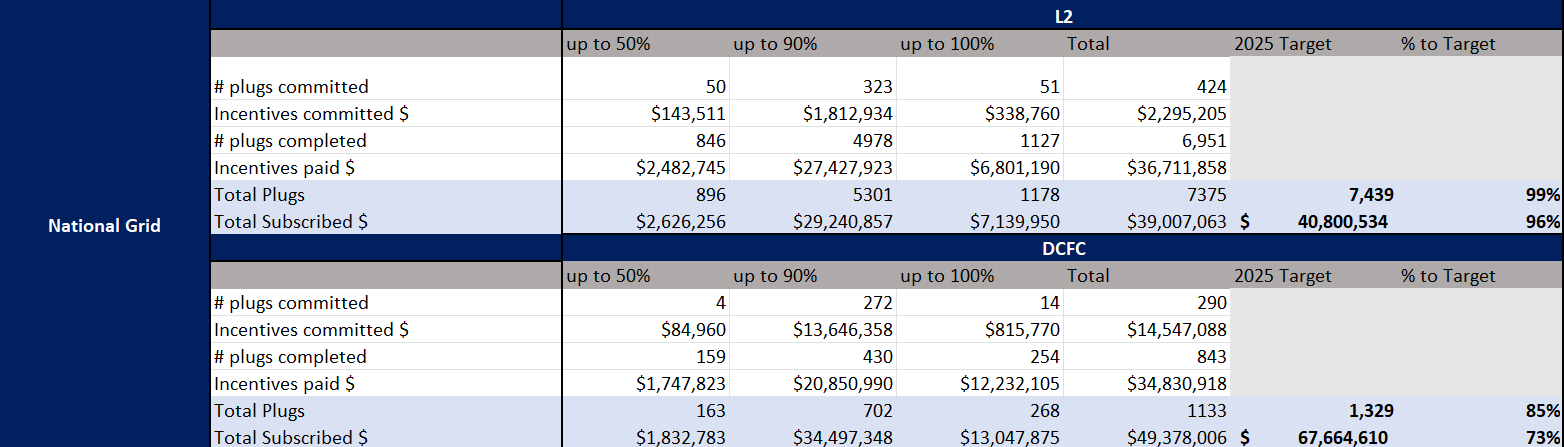

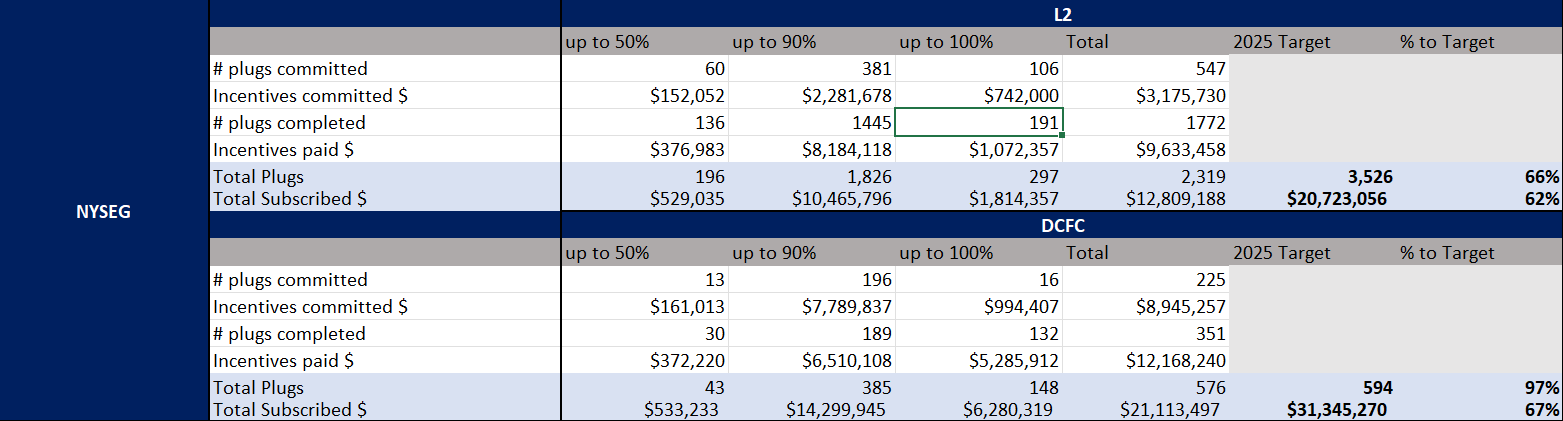

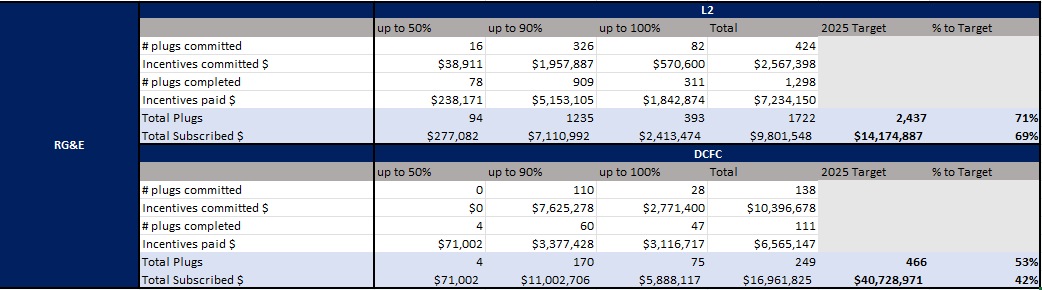

Plug and Budget Tracker

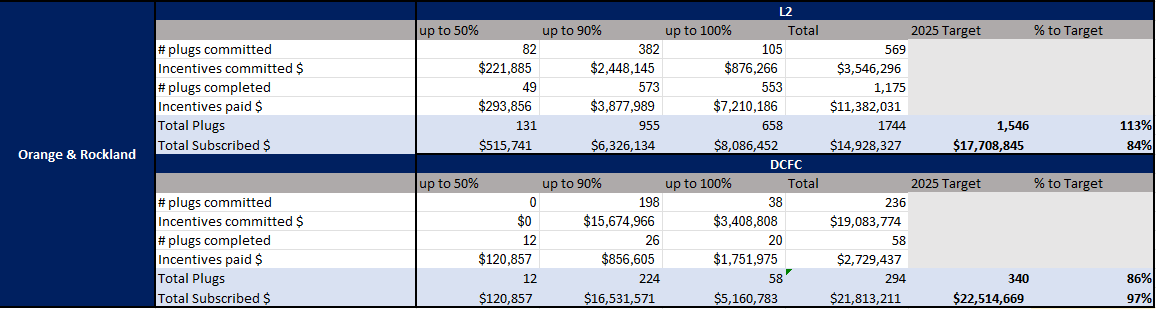

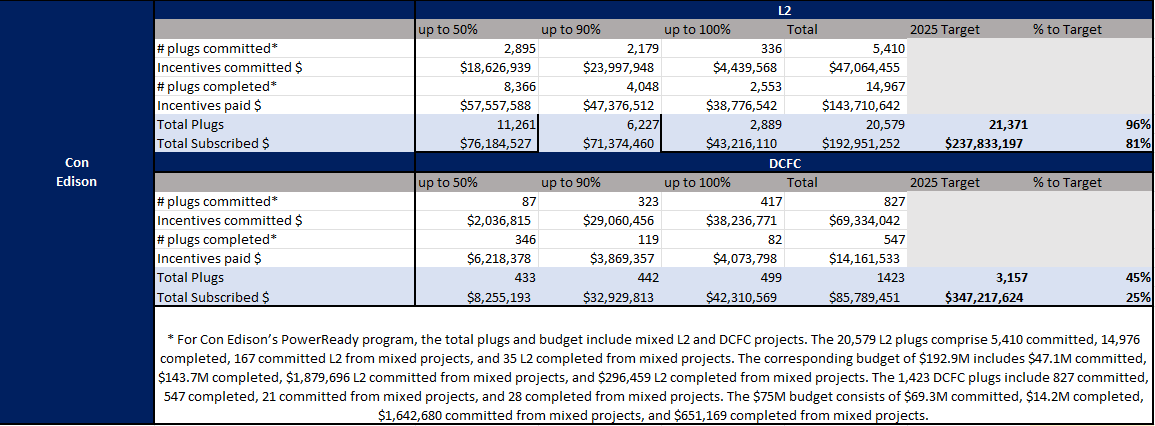

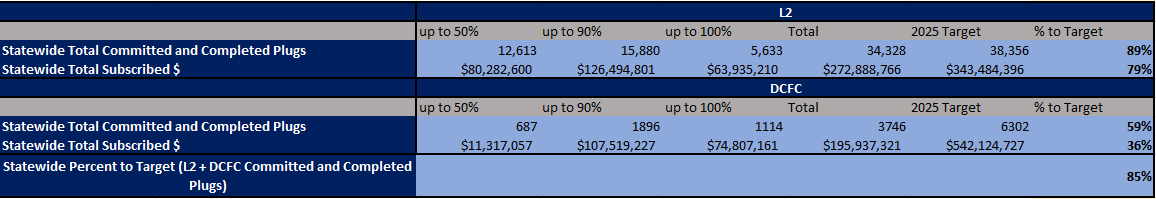

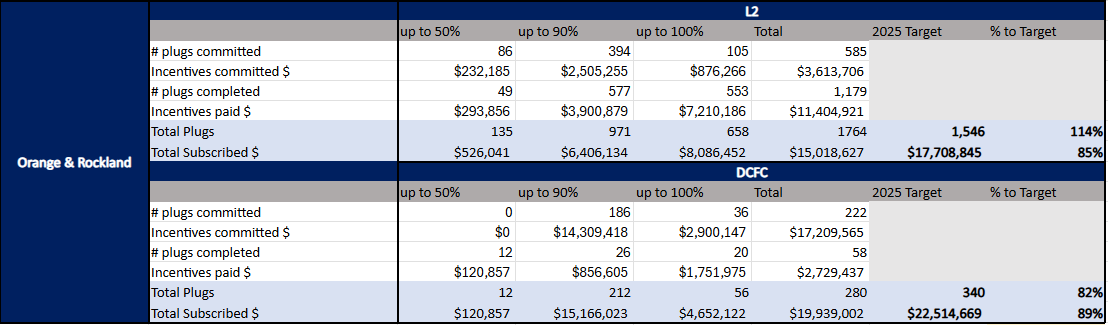

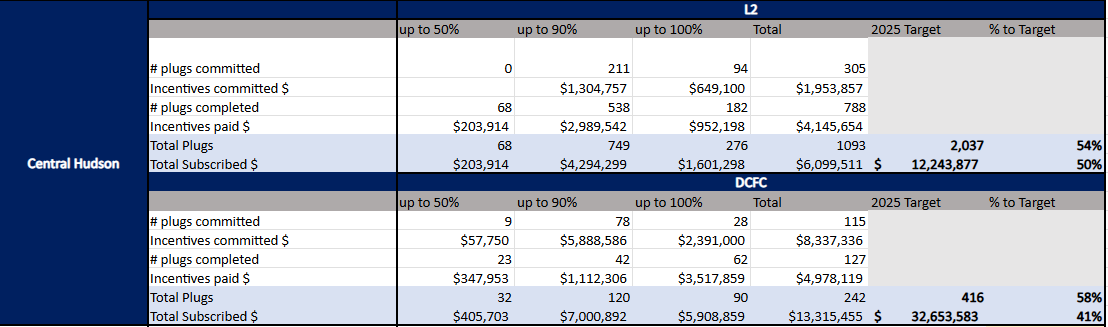

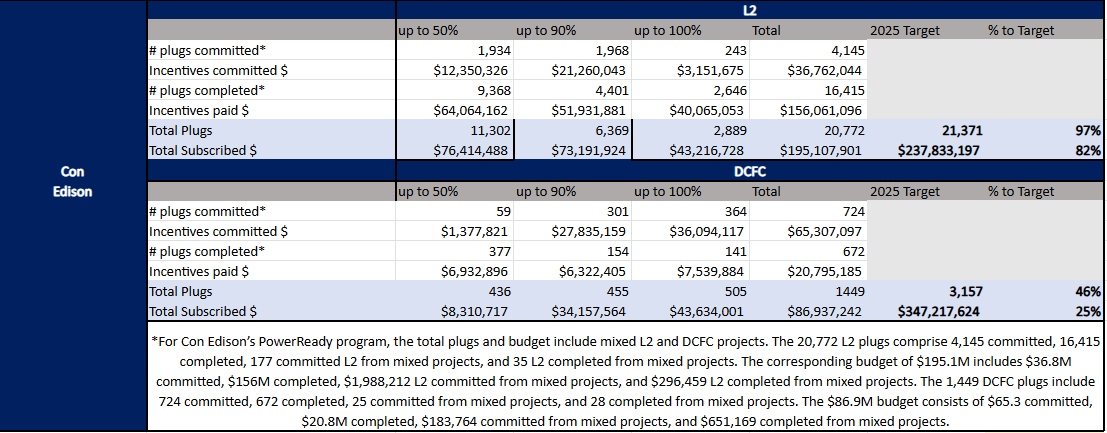

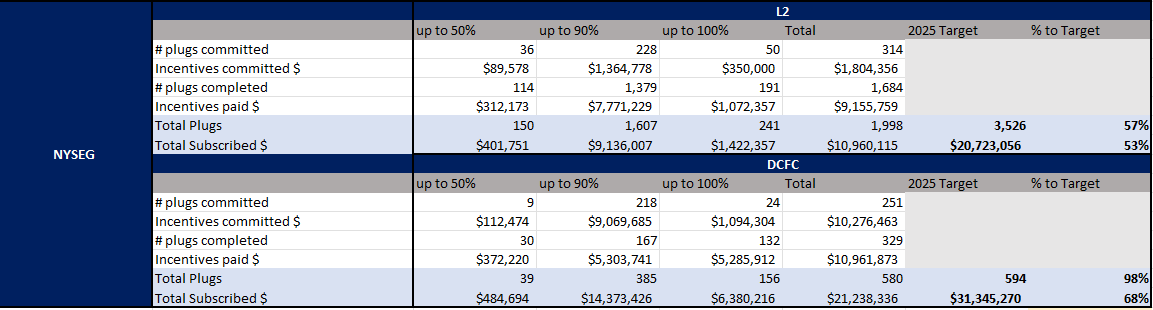

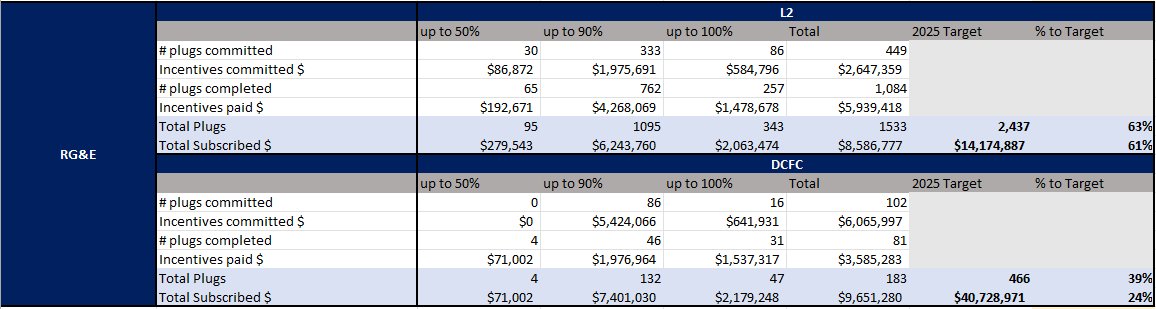

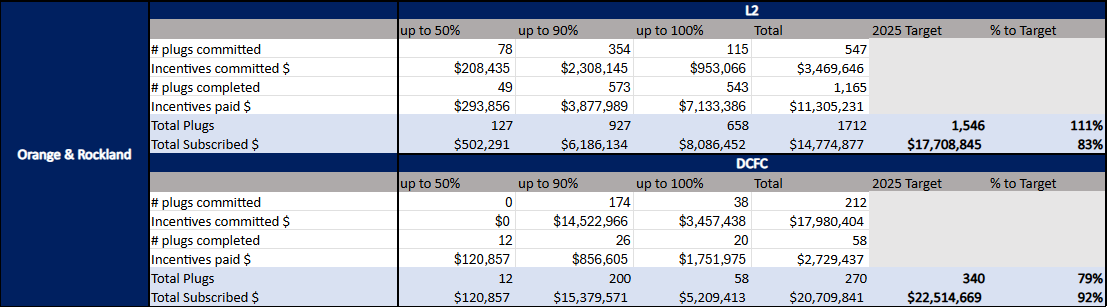

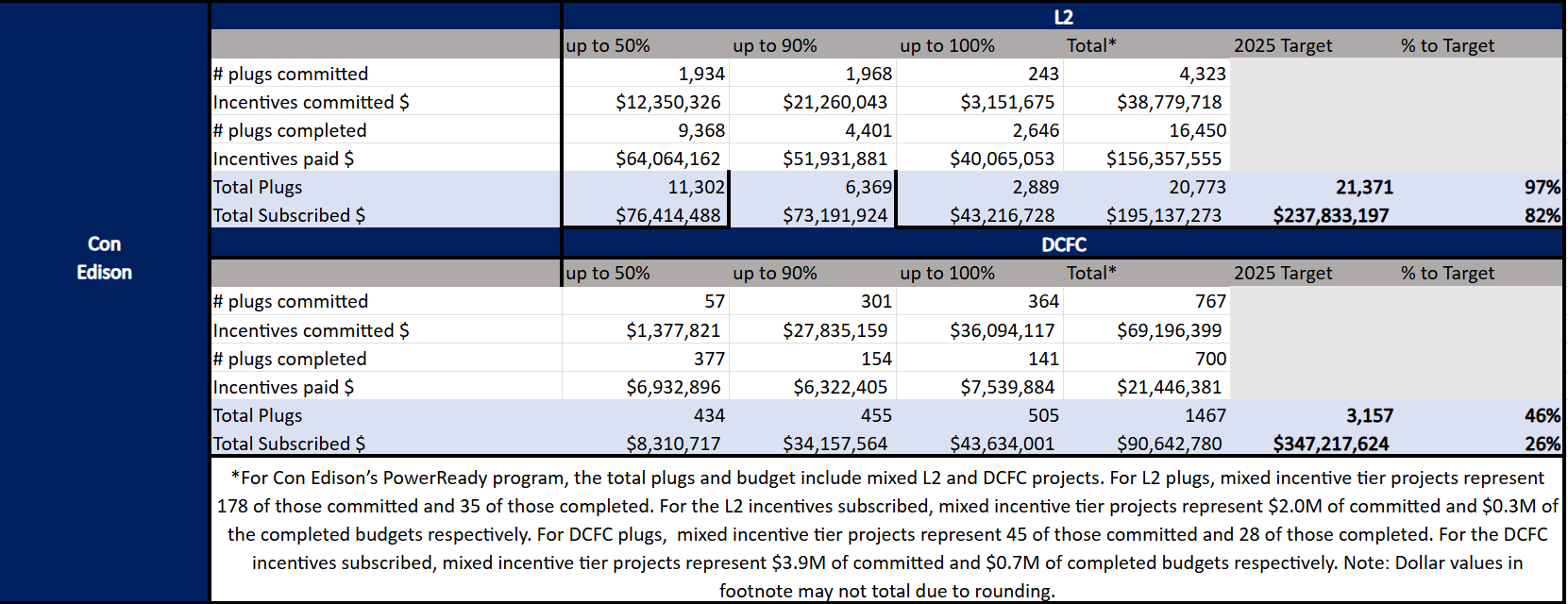

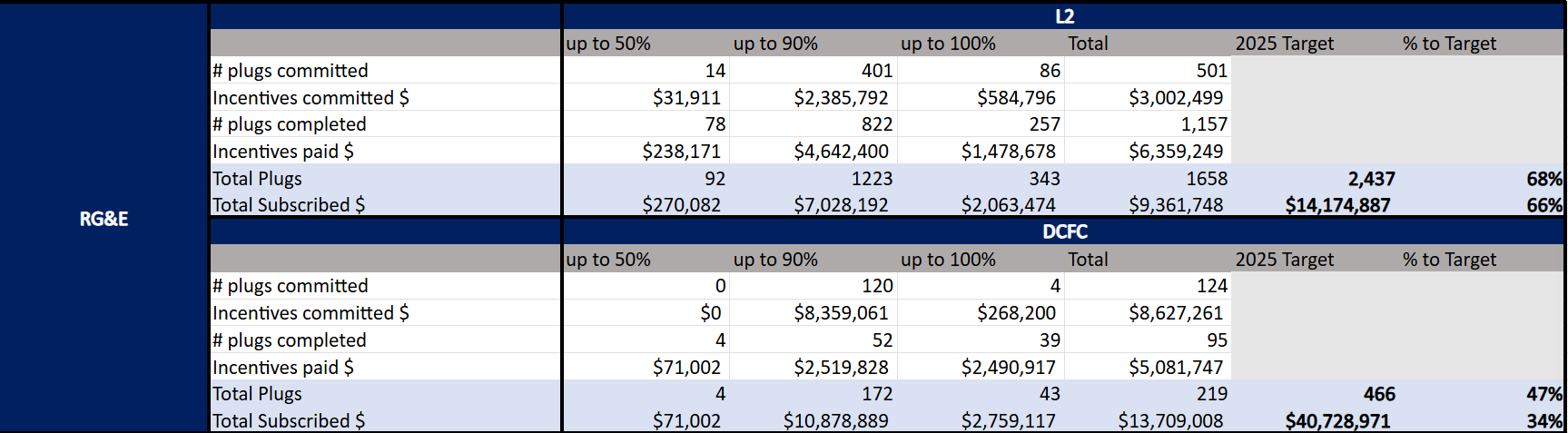

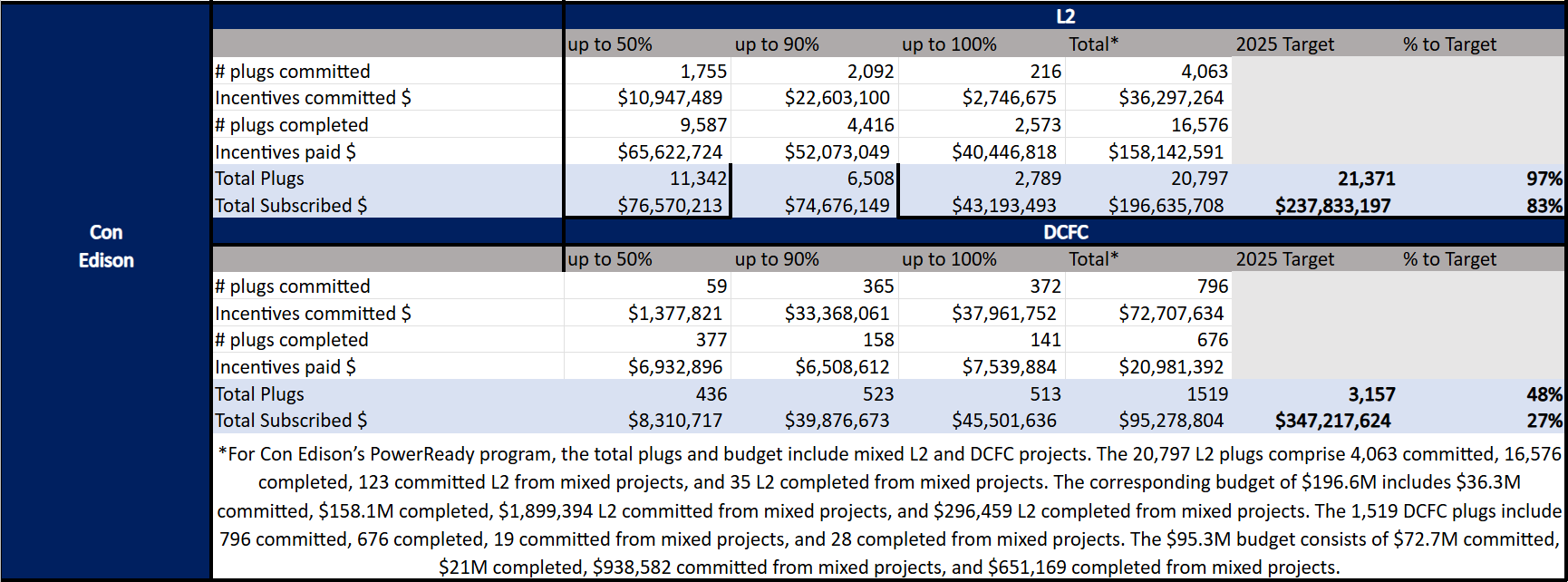

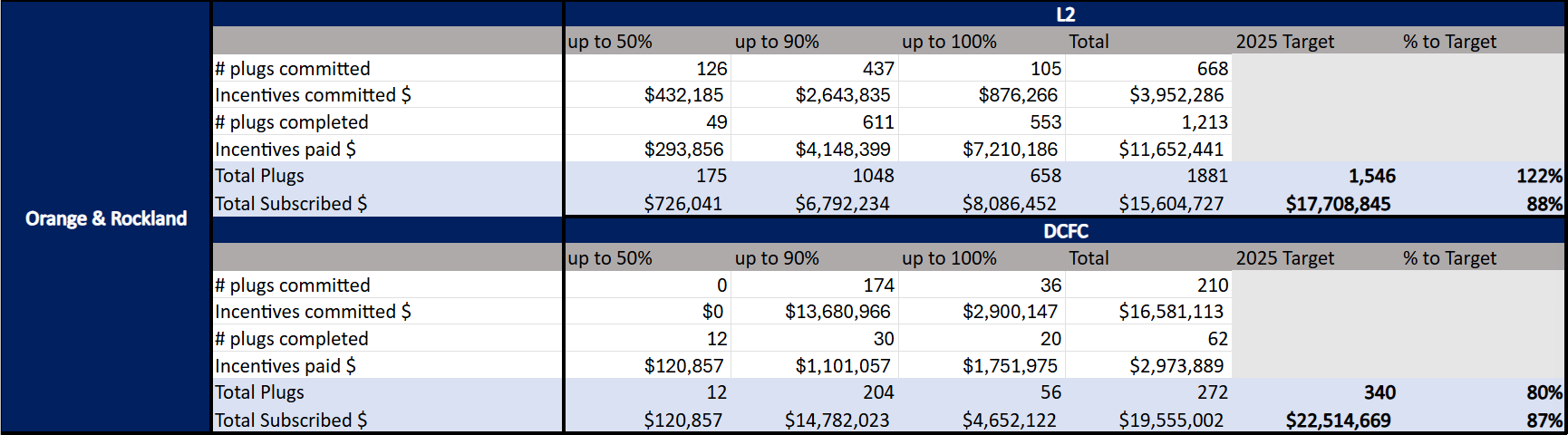

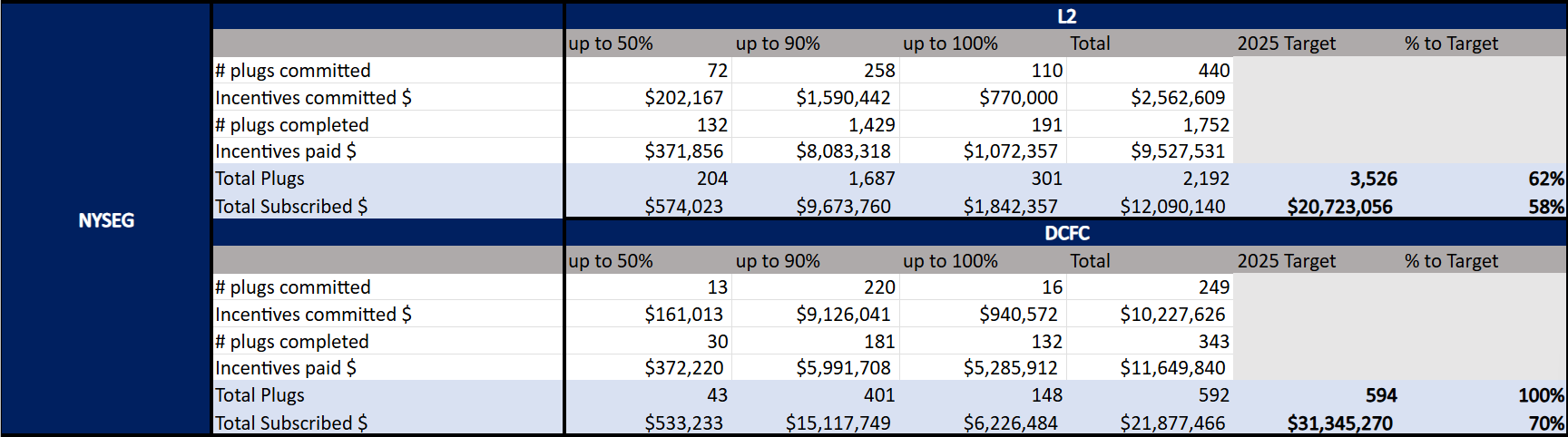

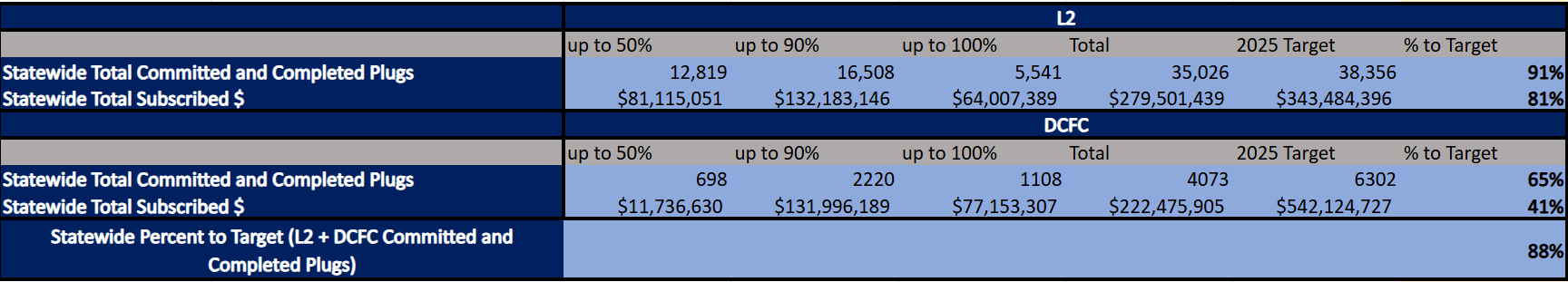

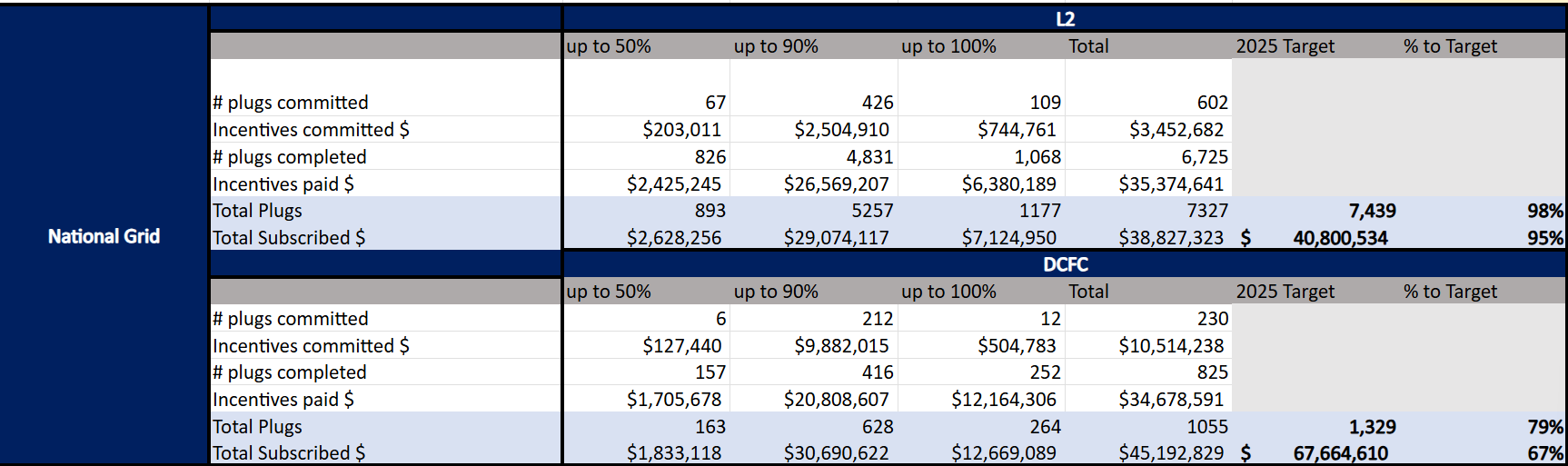

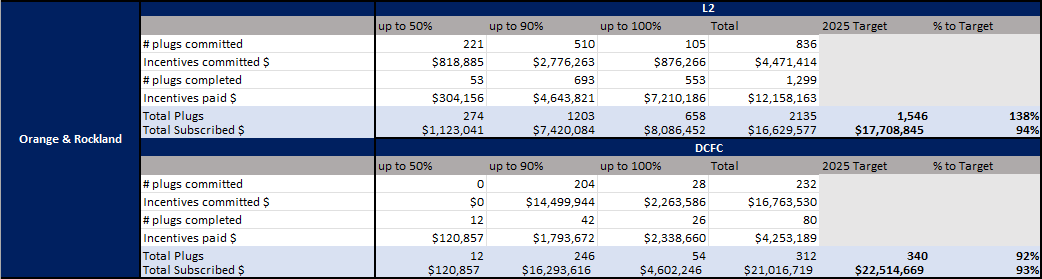

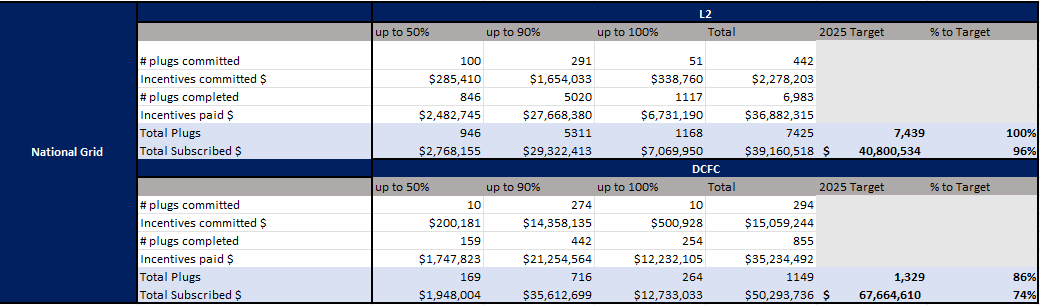

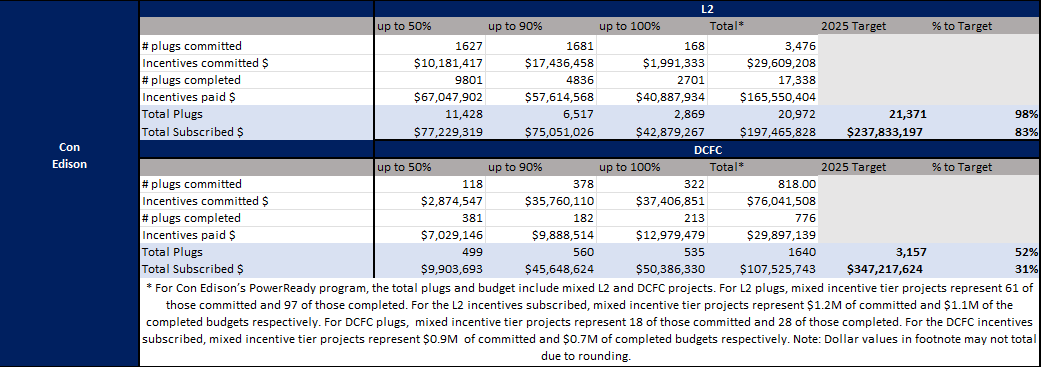

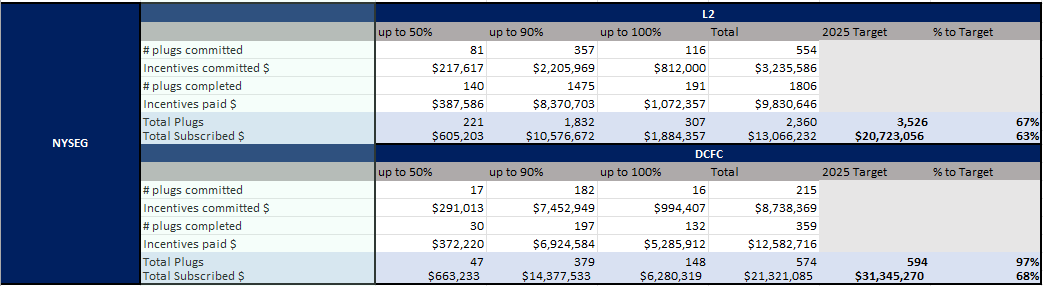

This table tracks progress toward 2025 plug goals and the amount of incentive funds that have been paid out to date. The data is updated monthly. The data is also available for download here.













This data was last updated in December 2024.
